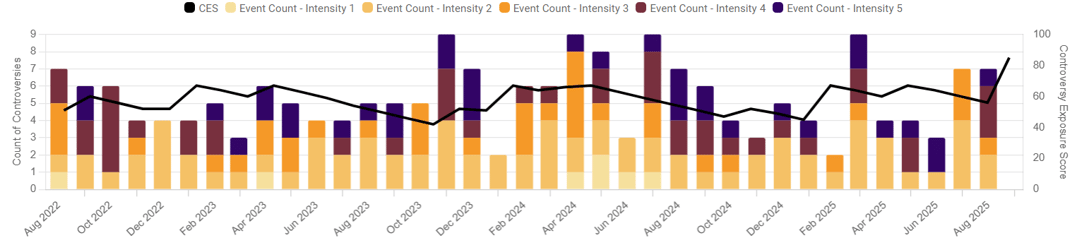

Córrego do Feijão Mine: ESG Challenges and Ongoing Controversies
The Córrego do Feijão Mine is facing serious ESG controversies following a dam collapse that resulted in 270 fatalities and contamination of the Paraopeba River. Indigenous villagers still lack safe land and access to clean water and food. The operating company, Vale, is dealing with ongoing legal challenges, including fines and criminal charges for negligence and bribery. Environmental and social impacts persist, with continued monitoring of water quality and safety risks from existing dams. Governance issues remain significant, highlighted by employee arrests and scrutiny over manipulated audits, prompting calls from local and international NGOs for improved remediation efforts and oversight of the mine’s operations.
Cerrejon Mine: Human Rights, Health, and Environmental Impacts
Cerrejón Mine faces significant ESG issues, particularly in environmental and social areas. Its expansion has displaced over 20,000 indigenous people, especially from the Wayúu community, leading to severe health problems and the deaths of 5,000 children. Environmental concerns include the diversion of the Bruno Stream, excessive water use during droughts, and significant air and water pollution. Labor unrest persists, with over 4,600 unionized workers striking over job cuts and unsafe conditions. The mine continues to face international criticism for violating local community rights and harming regional ecosystems.

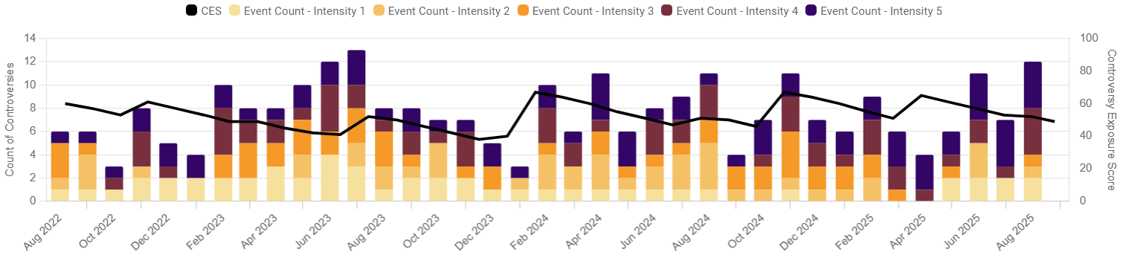

Samarco Mine: Escalating ESG Challenges and Corporate Accountability
Samarco Mine faces intense ESG scrutiny nearly a decade after the 2015 Fundão dam collapse, with over 700,000 claimants in a $44 billion lawsuit for contaminated water and pollution. The operator risks bankruptcy due to environmental liabilities and failed debt restructuring, exacerbating financial instability. Ongoing issues include heavy metal contamination in wildlife and dust pollution exceeding health standards, prompting NGOs to demand the operator's removal from the UN Global Compact. Governance concerns have risen with employee arrests linked to safety protocol violations and falsified audits, raising questions about corporate accountability.
The ongoing ESG challenges in the mining sector highlight significant environmental, social, and governance failures that profoundly impact affected communities. The cases of Córrego do Feijão, Cerrejón, and Samarco reveal the dire consequences of prioritizing profit over sustainability. Mining companies must embrace accountability, transparency, and community engagement to rebuild trust and ensure a positive impact.
Reach out to SESAMm
TextReveal’s web data analysis of over five million public and private companies is essential for keeping tabs on ESG investment risks. To learn more about how you can analyze web data or to request a demo, reach out to one of our representatives.
SESAMm Incorporates Generative AI to Enhance ESG Risk Mitigation and Process Efficiency in the Finance Sector
FOR IMMEDIATE RELEASE
PARIS, France - July 12, 2023 - SESAMm, a leading player in financial technology, announces a transformative initiative to incorporate Generative AI solutions into its operations and product offerings. This strategic move is geared towards assisting financial firms in enhancing risk mitigation focused on ESG controversies and streamlining their processes.
The implementation of Generative AI follows a three-pronged strategic approach. This comprises the integration of large language models into their tech stack, the development of a client-facing conversational agent, and fostering a culture of AI utilization across all teams.
"With Generative AI, we are not only enhancing our internal processes but also focusing on the development of new features that redefine industry standards," stated Sylvain Forté, CEO & Co-founder of SESAMm. "These include intuitive dashboards, automated ESG/SDG event analysis tools, and a client interaction chatbot - all created to streamline data interaction and boost efficiency in risk management."
The integration of Generative AI has significantly enhanced SESAMm's product functionality already. This includes quicker and more intuitive interaction with data and introducing new features, such as ESG/SDG event summarization and automatic competitor searches for public and private companies.
SESAMm is also employing Generative AI for advanced risk mitigation. "Our innovative approach provides our clients a virtual team of ESG analysts and experts for detecting risk and ESG controversies, enhancing their risk mitigation strategies in a robust and comprehensive manner," Forté added.
SESAMm is preparing to launch a suite of AI-powered features later this year. "These new features, powered by Generative AI, reinforce our commitment to developing solutions that enhance risk mitigation and streamline processes for financial firms," Forté emphasized.
To explore more about SESAMm's Generative AI solutions and how they can boost your firm's operations, watch the video below:
Also, make sure you join our upcoming webinar, where Sylvain Forté will discuss live the future of fintech with Generative AI and how SESAMm is incorporating Generative AI into its processes and products. To register for the webinar, click here.
About SESAMm
SESAMm is a leading artificial intelligence and NLP (natural language processing) technology company serving global investment firms, corporations, and investors, such as asset managers, banks, private equity firms, hedge funds, and index providers. With over 100 employees and six offices worldwide, SESAMm celebrated its 9th anniversary in 2023.
An analysis of over 250,000 infrastructure projects reveals that the sector most often filed under "clean energy" carries the heaviest environmental and social controversy footprint of any asset type assessed.
In the taxonomy of energy infrastructure, hydropower occupies a comfortable position. It is renewable, dispatchable, and long-lived, and it enters transition frameworks, green bond eligibility criteria, and net-zero roadmaps with minimal friction. Where coal is a legacy liability to be managed down and nuclear invites a specialized debate, hydropower is largely treated as settled. What these projects have actually done does not support that treatment.
Belo Monte, an 11,233 MW complex on the Xingu River in Pará, Brazil, is the sharpest test of the point, because it was built to answer this exact objection. Approved after decades of opposition to a far larger design, it was engineered as a run-of-river plant to minimize flooding, and its reservoirs cover 478 km², of which 274 km² was already river channel at high water, a 61% reduction compared with the 1980s proposal, according to the operator's own regulatory filing. The mitigation was designed from the start, and everything that follows happened regardless.
Biodiversity: the cost of a physical footprint
Environmental controversy across infrastructure concentrates on industrial accidents, water pollution, and biodiversity, and hydropower leads the third, outright, because dams require the permanent conversion of river systems and the land around them. Mexico's Federal Electricity Commission won environmental approval in September 2014 for the Las Cruces dam on the San Pedro Mezquital, upstream of Marismas Nacionales, a Ramsar-protected wetland, even though the project's own impact statement conceded that the damage to Indigenous ceremonial sites could not be mitigated. Along the Mekong River, river health and fish populations fell as dam construction spread through the basin. In Brazil, the Doce River carried a mass release of toxic material after an upstream failure. Elsewhere, the record includes violations of the Endangered Species Act and documented disruption to rainfall patterns.
At Belo Monte, the consequences have been measured rather than projected. The plant diverts water into a canal that bypasses a 130-kilometer stretch of the Xingu known as the Volta Grande, which has received less than 30% of its natural annual discharge since 2019, and some 86% of the stretch's seasonally flooded vegetation, 30,748 of 35,600 hectares, can no longer be inundated at all. The gap lies in the regulator's own file: IBAMA's technical staff called for 10,900 cubic meters per second in February, the historic peak month, compared with the 1,600 that the operating regime actually releases. Seven years of underwater video survey data published in Scientific Reports recorded total fish species richness falling from 62 to a post-operation average of 51, with the steepest losses near the dam and in the rocky rapids, which hold roughly 2.6 times as many species as sandy reaches. The zebra pleco, whose entire known range lies inside the dewatered stretch, now sits on Brazil's national list of threatened species as critically endangered.
None of this is an accident or a failure of operation. It is a structural consequence of the asset. A well-run dam still floods a valley, and a dam engineered specifically not to flood one still dewater the river below it.
When engineering fails: hydropower's physical risk profile
Coal mining leads infrastructure on industrial accidents, where the record is dominated by human tragedy and safety negligence: explosions, collapses, fires, and repeated, incremental failures. Hydropower ranks second, but its accidents take a different form, because in this sector, industrial failure means catastrophic engineering failure at scale. The record includes pipe ruptures causing severe land erosion, oil leaks, and dam collapses that killed and displaced people across whole regions, while PG&E's settlement over damages to the Middle Fork American River Hydroelectric Project and the litigation still running in Brazil after dam collapses give a sense of the exposure a single event can generate. For anyone underwriting these assets, the distinction is financial as much as physical: a coal mine's safety record is a rising cost curve, while a dam's structural integrity is a low-probability, near-unbounded loss.
At Belo Monte, that exposure has so far been financial. The project was budgeted at R$28.9 billion when Brazil's development bank approved a then-record R$22.5 billion loan in November 2012, and by late 2017, actual investment had reached R$38.6 billion, roughly 34% over. The operator owed R$28.3 billion to lenders and debenture holders at the end of 2024. Aliança Norte Energia Participações, the Vale and Cemig vehicle holding a stake in the project, discloses a possible loss of R$3.05 billion from a single construction-delay claim and describes the operator's liquidity as its principal point of attention and a source of investor alert. Neoenergia wrote off its own 10% holding by R$482 million in the fourth quarter of 2021.
The physical risk has been closer than the absence of a collapse suggests. In October 2019, the operator wrote to the national water regulator declaring an emergency, because reservoir levels had fallen far enough to expose an unprotected section of the Pimental dam's earthfill base to wind-driven wave erosion and, in the company's own words, structural damage. It cut outflow below the level agreed with the environmental regulator to protect the structure, and the letter surfaced only through investigative reporting.
Beyond the environment: displacement, water, and chronic corruption
Right to property
Hydropower ranks first among infrastructure sectors for property disputes, a direct function of the footprint a dam and reservoir require. The record shows land seizures, forced displacement, compensation that arrives short or not at all, communities never consulted before ground was broken, and blasting that cracked the foundations of nearby homes. Those affected are frequently the least equipped to hold an operator to account.
Fifteen years after Belo Monte broke ground there is still no audited count of who lost their homes. Estimates run from 20,000 to 40,000 depending on the definition used, against the operator's account of rehousing some 6,000 urban families. Landowners say expropriations are priced at unadjusted 2013 values while the project's own construction boom inflated the market, and as of 2025 none of the land required for the riverine resettlement program had been bought. A petition filed with the Inter-American Commission in 2011 still has no ruling.
Community health and safety
Hydropower sits alongside coal and nuclear as a leading source of community health disputes, but it arrives by a different route. Coal delivers PM2.5, nuclear delivers radioactive anxiety, and hydropower delivers water mismanagement: overconsumption that strips farmers of a livelihood, contaminated water reaching local crops. The grievance is agricultural rather than industrial, which widens the affected population considerably.
On the Volta Grande, catch per fisher fell from 11.1 kilograms a day between 2001 and 2008 to 4.53 kilograms between 2020 and 2023. A randomized household survey found 38.5% of residents in Belo Monte's resettlement neighborhoods living with moderate or severe food insecurity, against 28.3% across the surrounding city. In June 2026, federal prosecutors sought as interim relief for 635 families along the reduced-flow stretch the emergency delivery of three and a half to five liters of drinking water per person per day.
Corruption and bribery
Corruption and bribery accounts for close to 30% of governance controversy across infrastructure. What separates hydropower is the pattern. In airports, nuclear, and coal, corruption surfaces as discrete scandals: a probe opens, executives are charged, attention fades. In hydropower it keeps returning, tied repeatedly to falsified records and payments to local officials to secure land and water rights. Isolated scandals point to isolated actors. A pattern that recurs points to how these projects get permitted.
Brazilian prosecutors alleged that Belo Monte's construction contracts carried bribes worth 1% of their value, and three contractors admitted cartel conduct and kickbacks under leniency agreements that carried immunity. Everything after that was procedural closure rather than a finding of liability: the principal defendants were acquitted and the acquittal upheld on appeal in 2024, the competition authority archived its bid-rigging case in 2025, and no individual has been convicted in connection with the project. An investor screening for enforcement outcomes would have found a closed file. The costs landed elsewhere, in permitting delay, financing conditions, and a minority stake that has been for sale since 2022 without a buyer.
Hydropower's risk concentration: what this means
Hydropower's classification as clean energy is accurate on the metric it was designed to measure, because generation is low-carbon. But carbon intensity is one dimension of sustainability, and it is not the dimension that produces operational friction, legal exposure, or the loss of a social license.
What drew sustained opposition to these projects was water rights, displaced communities, cracked foundations, converted wetlands, and permits secured through local payments. None of it appears in a carbon accounting framework.
For investors, insurers, and lenders seeking transition-aligned infrastructure exposure, that is a material blind spot: an asset class that screens well on the primary criterion while carrying the heaviest social burden in the dataset, and carrying it on behalf of people who have no employment relationship with it. Belo Monte was engineered to avoid precisely that outcome and produced it regardless, which suggests the exposure is not a function of how a dam is built but of what a dam is.
The label is not wrong. It is simply measuring something other than risk.
